Kanban WIP limits are explicit caps on the number of work items allowed in any stage of your board at one time. Start your experiment today: set your “In Progress” column limit to roughly twice the number of people working that stage, then run it for a couple of weeks without changing anything else. Teams that do this consistently see shorter cycle times and far less task-switching within the first sprint.
Here’s what to do right now:
That single change is enough to surface your first real bottleneck.
WIP limits work because they force finishing over starting, and the number you set matters far less than the conversation it triggers when the column is full.
| Point | Details |
|---|---|
| Start with one limit | Set “In Progress” to roughly 2 items per person and run a short experiment before making changes. |
| Measure before and after | Record cycle time and throughput as a baseline; a working limit reduces cycle time without dropping throughput. |
| Treat breaches as signals | When a column hits its cap, swarm, escalate, or reprioritize — never ignore the breach or route around it. |
| Not every column needs a cap | Focus limits on active work stages; backlog and “Done” columns rarely benefit from explicit WIP constraints. |
| Seven supports the experiment | Seven boards offer configurable columns, overdue alerts, and full data export so your WIP data stays yours. |
WIP limits are explicit caps placed above board columns that prevent teams from pulling new work until existing items move forward. The logic is grounded in Little’s Law: Cycle Time = WIP / Throughput. Lower your WIP without changing throughput, and cycle time drops proportionally. It’s not a theory; it’s arithmetic.
The four Kanban principles that make limits effective are: visualize all work so nothing is hidden, limit WIP so flow stays predictable, manage flow actively rather than managing people, and make policies explicit so everyone knows the rules. WIP limits are where the second and fourth principles meet. Without an explicit number, “limit WIP” stays a slogan. With one, it becomes a daily decision rule.
Pull-based flow is the mechanism underneath. Instead of pushing work onto whoever is next in line, teams pull only when capacity exists. The WIP limit is what defines “capacity exists.” When a column is full, the signal is clear: help finish something before starting anything new.
The gains are real, but they’re not uniform across every team or workflow.
Software teams tend to see the most dramatic cycle time improvements because their work is relatively uniform in size. Support teams benefit most from the bottleneck visibility. Marketing and content teams often find the biggest win is in priority clarity, since their work tends to be highly variable in scope and urgency.
The before/after picture is worth stating plainly. A team with no limits and 15 items in progress across five people is effectively working on three things each, simultaneously. Set a column limit of 8 for that same team and the board immediately shows which items are stuck, which are moving, and where help is needed.
This is a five-step process. Run it as a 30-day experiment, not a permanent policy.
Map your workflow and decide column granularity. List every stage work passes through, from backlog to done. Decide whether “In Review” and “In Testing” are separate columns or one. More columns give finer visibility; too many create overhead. For most teams, 4–6 columns is the right range. Note: not every column needs a WIP limit. Backlog columns and “Done” columns rarely benefit from caps. Focus limits on active work stages.
Count current actual WIP and measure your baseline. Before setting any limit, record how many items are in each active column right now. Also log your current average cycle time and weekly throughput. Without this baseline, you can’t tell whether the experiment worked.
Choose initial limits using a starting formula. A common rule of thumb is 2 items per person for development columns. For a 4-person dev team, a column limit near 8 is common. For review or testing stages with fewer reviewers, scaling down to about 1.5 times the number of people assigned to that stage can be a reasonable starting point. Start with limits slightly below your current averages so the constraint is real but not paralyzing.
Enforce limits as conversation triggers, not hard blocks. When a column hits its limit, the team’s response should be a question: “What can we finish right now?” not a software error message. Define your breach response explicitly before you start: swarm on the blocked item, escalate if it’s externally blocked, or reprioritize if something more urgent arrived. Write this policy down and post it on the board.
Measure, review, and adjust every two weeks. After each two-week window, compare cycle time and throughput against your baseline. If cycle time dropped and throughput held steady or improved, the limit is working. If the column is almost never full, loosen it. If the team is constantly swarming, tighten it or investigate the upstream cause.
Meeting cadence: A daily flow standup (10 minutes, focused on blocked items and column fullness) catches problems fast. A weekly flow review (30 minutes) looks at the cumulative flow diagram and throughput trend. A biweekly retrospective ties WIP data to team behavior and adjusts limits.
Who owns the experiment? Assign one person, typically a team lead or Kanban coach, to track the metrics and facilitate the reviews. Everyone on the team owns the behavior; one person owns the data.
Pro Tip: For teams with highly variable task sizes, count by story points rather than raw item count. A column limit of 13 points behaves more predictably than a limit of 3 items when one of those items is an epic and two are bug fixes.
Different teams need different constraint structures. Here’s how the main patterns compare:
| Pattern | How it works | Best for | Watch out for |
|---|---|---|---|
| Per-column | Cap on items in each board column | Single-stream software teams | Doesn’t catch individual overload |
| Per-person | Each person has a personal item limit | Specialist teams, solo contributors | Hard to enforce in shared columns |
| Per-team (CONWIP) | Total WIP across all active columns is capped | Cross-functional, multi-stage flows | Requires strong flow discipline |
| Swimlane caps | WIP limit applied within a specific lane | Support vs. feature split, class-of-service | Adds governance complexity |
Per-column limits are the most common starting point and the easiest to explain. They work well when work flows through a predictable sequence and team members share columns.
Per-person limits make sense when individual multitasking is the core problem and when people work in parallel rather than in sequence. They’re harder to visualize on a shared board but can be tracked with a simple personal WIP rule posted in the team agreement.

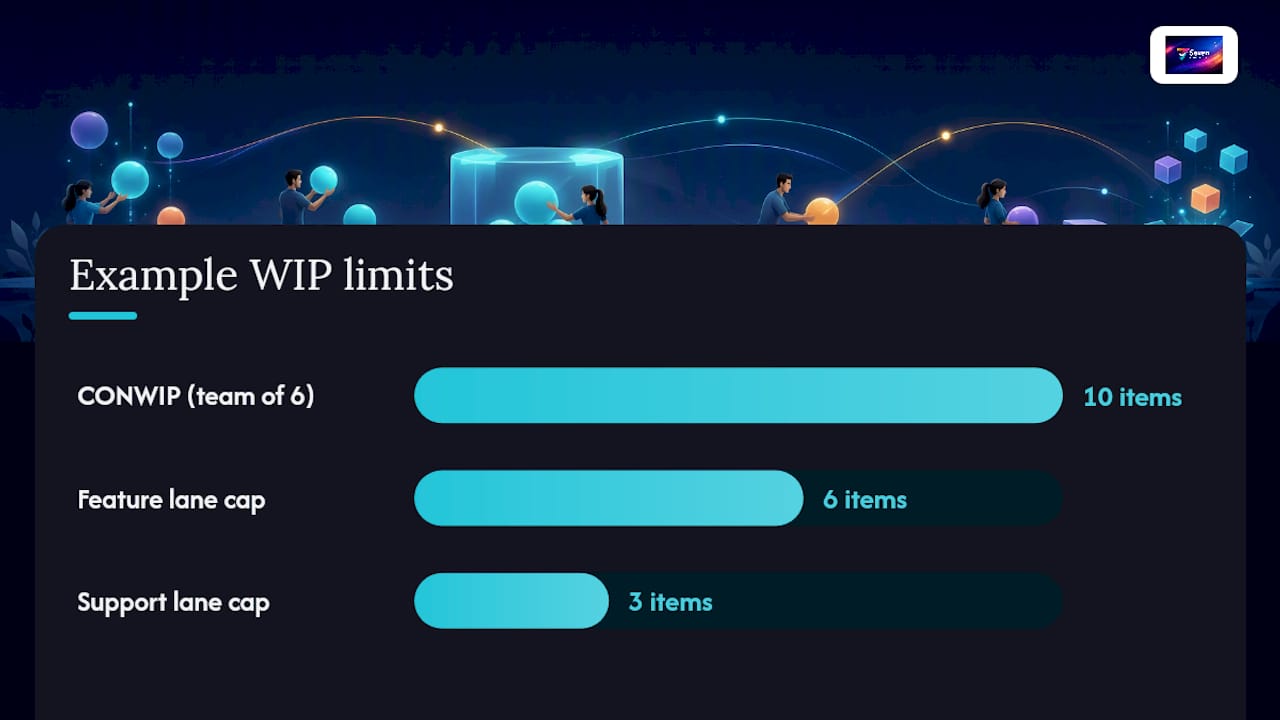

CONWIP (Constant Work in Progress) caps the total number of active items across all stages. A team of 6 might set a total WIP of 10, regardless of where those items sit. This approach suits cross-functional teams where work doesn’t follow a strict left-to-right column sequence. The governance challenge is that it requires the team to self-organize around the total, which demands more maturity.
Swimlane caps combine column limits with lane-level constraints. A support lane might cap at 3 items while a feature lane caps at 6. Pairing swimlanes with WIP limits forces useful prioritization conversations that a single column limit can’t trigger. The trade-off is added complexity in tracking and enforcement.
Combining patterns is legitimate. A team might use per-column limits for their main flow and add a swimlane cap for urgent/expedite items to prevent those from consuming all capacity.

Track these five, in this order of priority:
Reading a cumulative flow diagram (CFD) is worth learning. The CFD shows the count of items in each stage over time as stacked bands. Widening bands in a specific stage mean work is accumulating there faster than it’s leaving, which is a bottleneck. Flat lines across the whole board mean throughput has stalled. A healthy CFD shows bands of roughly consistent width moving steadily to the right.
Run each experiment for at least 2–4 weeks before drawing conclusions. Weekly throughput is noisy; you need enough data points to see a trend rather than a fluctuation.
A breach is a signal, not a failure. The right response is a conversation, not a workaround.
Policy template: When column X reaches its limit, the team applies one of three responses within the same day:
The escalation flow matters. Identify who makes the call (team lead, product owner, or both), what information they need (which item, why it’s blocked, what unblocking requires), and how long they have to respond before the team escalates further.
Azure Boards treats WIP limits as soft constraints that highlight when a column exceeds its cap rather than blocking movement entirely. That’s the right model. Hard blocks that prevent card movement create frustration and workarounds. A visual highlight that triggers a conversation creates learning.
Pro Tip: *Log every breach: date, column, cause (blocked, new priority, misestimate, or team agreement to exceed), and resolution. Review the breach log in your biweekly retrospective. After 4–6 weeks, patterns emerge.
Use these as starting points, not permanent settings. Adjust after your first two-week review.
Single-stream dev team (4 people): In Progress = 6, In Review = 3, In Testing = 2. Tighten In Progress to 4 if cycle time stays above two weeks after the first experiment.
Support + feature split (swimlanes, 6 people): Support lane: In Progress = 3, In Review = 2. Feature lane: In Progress = 6, In Review = 3. Total board WIP = 14. This configuration protects planned feature work from being consumed by reactive support volume.
Content/marketing board (4 people): In Progress = 4 (count by piece, not by task), In Review = 2, In Approval = 2. Marketing work tends to have longer review cycles, so the In Review cap is deliberately tight to surface delays early.
The rationale in each case is the same: set the limit low enough that it creates occasional pressure, but not so low that the team is constantly blocked. If the column is never full, the limit isn’t doing anything.
Most teams hit at least two of these in the first month.
When WIP limits won’t fix the problem: if the team is consistently blocked by external dependencies, a resource shortage, or unclear requirements, lowering the WIP limit won’t help. It will just make the blockage more visible, which is useful for diagnosis but not a cure. Address the root cause directly: fix the dependency, hire for the shortage, or improve the definition-of-ready process.
Swimlanes are horizontal rows on a Kanban board that group work by class of service, team, or responsibility. A swimlane diagram groups process steps by actor and makes handoffs visible in a way that column-only boards can’t. When a support team and a feature team share a board, swimlanes let each stream have its own WIP limit without collapsing everything into a single column cap.

Swimlanes visually separate responsibilities and help identify where delays and handoffs occur. Without a WIP limit, a swimlane is just a visual organizer. With one, it becomes a capacity constraint that forces the team to decide what matters most when the lane is full.
For class-of-service lanes such as expedite, standard, fixed-date, or intangible, the expedite lane often carries a very low WIP limit to prevent it from absorbing excessive urgent work. That single constraint prevents the expedite lane from becoming a dumping ground for anything someone calls urgent.
In multi-team contexts, CONWIP often outperforms per-column limits because it accommodates the irregular flow patterns that emerge when work crosses team boundaries. Set a total WIP for the shared board, then let each team self-organize within that constraint. Cross-team replenishment meetings (weekly or biweekly) become the mechanism for deciding what enters the shared pool.
Pro Tip: When modeling a multi-team board with swimlanes, draw the handoff points explicitly. Mark where work moves from one lane or team to another. Those handoff points are where WIP accumulates most. Apply your tightest limits there first.
This is a disciplined experiment, not a one-time setup.
Days 1–30: Establish the baseline and run the first experiment
Days 31–60: Refine limits and add metrics
Days 61–90: Scale or stabilize
Hand off progress to product owners at day 30 and day 60 with a brief written summary: current limits, key metric changes, and the next planned adjustment. This keeps leadership informed without requiring them to attend every flow review.
Most articles on WIP limits treat the number as the answer. Pick 2 per person, set it, done. That framing is why so many teams set limits and then quietly stop enforcing them three weeks later.
The number is not the point. The conversation the number forces is the point. When a column hits its limit and the team has to decide whether to swarm, escalate, or reprioritize, that decision reveals something real about how work actually flows, where the real bottlenecks are, and whether the team’s stated priorities match their actual behavior.
Teams that treat WIP limits as a policy to comply with get marginal results. Teams that treat them as a diagnostic instrument get genuinely useful data. The difference is whether the breach triggers a conversation or a workaround.
Start smaller than you think you need to. One column, one limit, two weeks. The experiment will tell you more than any formula.
